Policy areas / Transport corridors and border posts
DeepSouth Africa · Zimbabwe · Mozambique · sources last checked 26 Oct 2026
Transport corridors and border posts
Which rules and facilities at the main Southern African corridors and border posts slow goods, and which reforms are underway?
Many cross-border investments depend on moving goods through a neighbour's ports, railways and border posts, under rules neither the investor nor its home government controls.
What the records cannot yet show, including how much trade each blocker holds back, is gathered in one place: evidence limits.

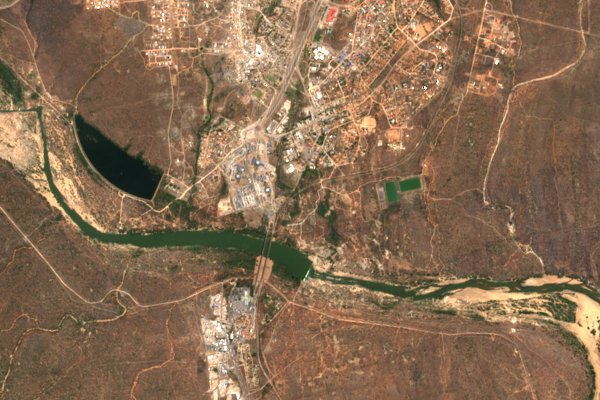

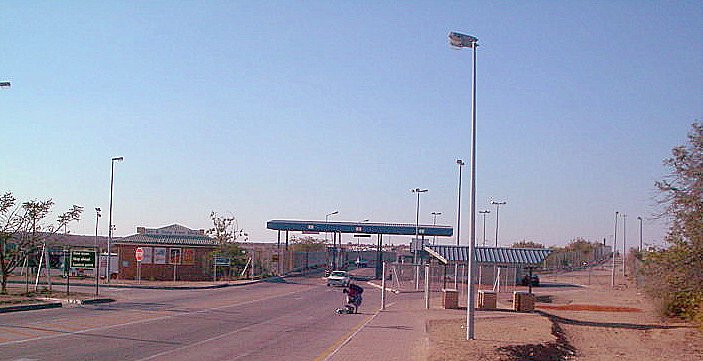

Border post of Beitbridge between South Africa and Zimbabwe.
Where it happens: infrastructure and documented constraints
The stations, lines and border posts this area's records name. Select a marker to open its record.
1 documented constraint and 3 reforms and projects have a place on this map. 3 other records are not drawn: they have no single location, or no source for their position has been found yet.
Constraint observedReform or projectApproximate position: a stand-in (see list)Lines between markers are straight, not real routes.RailwaysMain roads (motorways and trunk roads)
Institutions are those the records name; where a quoted source says what one does on a reform, that role is shown on the reform's page. Positions checked 2026-10-26. Outlines: Natural Earth (public domain). Power lines, railways and roads: OpenStreetMap contributors (ODbL 1.0). The map places records; it is evidence for nothing, and a marker's shape comes from the record, not the place.
From above
Each image shows one place on one day, north up, at 10 metres a pixel. It shows the place, not congestion, delays, progress or use.
Regulator established in law1 Apr 2025commenced 1 April 2025; s.29(1): "The Transport Economic Regulator is hereby established as an organ of state within the public administration"Economic Regulation of Transport Act 6 of 2024, with commencement history · commencement history; s.29(1) · 1 Apr 2025not yet checked by a personTransport Economic Regulator under the Economic Regulation of Transport Act (the Regulator's chapter in force; the rail access chapter listed as not yet commenced in the version read)
Construction to begin at some portstarget later this year or early next year (said 28 April 2026)"construction will begin later this year or early next year for some ports", with a "phased rollout" over "about a two-to-three-year period" (about three years at Beitbridge and Lebombo)BMA announces successful bidders for major border overhaul · article text · target: later this year or early next year (said 28 April 2026)not yet checked by a personRedevelopment of six land ports of entry (public-private partnership)
Durban Pier 2 concession takes effect1 Jan 2026"Transnet and International Container Terminal Services Inc (ICTSI) have signed a 25-year agreement"; "Effective from 1 January 2026, the partnership will enable investment of more than R11 billion"Operation Vulindlela Phase II, Q3 2025/26 progress report · printed p.8 / PDF p.12, Reform 2 key milestones · 1 Jan 2026not yet checked by a personPrivate participation in ports and rail (terminal concessions and corridor projects)
Regulator's board (target)target Apr 2026 · completed"Operationalise the Transport Economic Regulator (TER) with appointment of Board" (April 2026)Operation Vulindlela Phase II, Q3 2025/26 progress report · printed p.9 / PDF p.13, Reform 2 next steps · target: Apr 2026not yet checked by a personTransport Economic Regulator under the Economic Regulation of Transport Act (the Regulator's chapter in force; the rail access chapter listed as not yet commenced in the version read)
Bidders named for six land ports28 Apr 2026the Border Management Authority named bidders for Beitbridge and Oshoek (Baobab Concession), Lebombo (Raulux Consortium), Maseru Bridge (Kgorong Consortium), Kopfontein (Kopfontein Consortium) and Ficksburg Bridge (Imbani Consortium)BMA announces successful bidders for major border overhaul · article text · 28 Apr 2026paraphrase, not a quotationRedevelopment of six land ports of entry (public-private partnership)
Access agreements with 11 train operators13 May 2026TRIM confirmed the agreements at a ceremony in Sandton on 13 May 2026; the operators are ARC South Africa, Barberry, Grindrod, Interlinks, IRACEMA, Menar, Minrail, Motheo Logistics, Sharp Logistics, The Railway Corporation and TLD MarineEleven private train operators gear up for mainline entry after concluding access agreements · article text · 13 May 2026paraphrase, not a quotationSecondary source: no Transnet release was found; the Q1 Vulindlela report (p.10) confirms the agreements but not their dateOpen access to the freight rail network for private train operators
Final Network Statement with tariff (target)target Aug 2026 · outcome not verifieda final Network Statement incorporating industry input and an updated access tariff, targeted for August 2026Operation Vulindlela progress report, Q1 2026/27 · p.10, next steps · target: Aug 2026paraphrase, not a quotationOpen access to the freight rail network for private train operators
Regulator fully operationaltarget Apr 2027"The TER will be fully operational from April 2027"Operation Vulindlela progress report, Q1 2026/27 · p.10 · target: Apr 2027not yet checked by a personTransport Economic Regulator under the Economic Regulation of Transport Act (the Regulator's chapter in force; the rail access chapter listed as not yet commenced in the version read)
Seven operators to start runningtarget the first quarter of 2027"the allocation of 41 slots"; "Seven of the eleven train operating companies (TOCs) allocated slots will commence operations on the" freight rail network "in the first quarter of 2027"Operation Vulindlela Phase II, Q3 2025/26 progress report · printed p.8 / PDF p.12, Reform 2 key milestones · target: the first quarter of 2027not yet checked by a personOpen access to the freight rail network for private train operators
Mozambique
Ground broken at Ressano Garcia17 Aug 2026"Mozambique has broken ground on a 980-million-metical (about R260m) modernisation of the Ressano Garcia border post"; the project was launched on 17 AugustWork starts on Ressano Garcia border upgrade · article text · 17 Aug 2026not yet checked by a personSecondary source: no Mozambican government statement was found; the article credits 360 MozambiqueModernisation of the Ressano Garcia border post (opposite Lebombo)
BMA places Beitbridge queues on the Zimbabwean side26 Jul 2026the BMA attributes the July 2026 queues to "congestion on the Zimbabwean side of the border"; Zimbabwean authorities cited limited parking, abnormal loads occupying bays and slower processing by clearing agentsBMA blames Zimbabwean bottlenecks for freight truck delays at Beitbridge · article text · 26 Jul 2026not yet checked by a personSecondary source: no BMA statement or Zimbabwean statement was foundFreight clearance and crossing times at Beitbridge, two observations 2025-26
ZIMRA expects the backlog largely cleared within a day if conditions stay stable28 Jul 2026in the reporter's words ZIMRA "says it is working urgently to clear heavy congestion at the Beitbridge Border Post", and the cause was "a combination of operational challenges affecting cargo processing on the Zimbabwean side"; ZIMRA is quoted directly: "ZIMRA is working with all border agencies to expedite cargo processing and restore normal traffic flow" and "We expect the backlog to be largely cleared within the next 24 hours, provided operating conditions remain stable"Zimbabwe: ZIMRA Moves to Clear Beitbridge Truck Backlog As Border Congestion Persists (New Zimbabwe, via allAfrica) · article text · 28 Jul 2026not yet checked by a personSecondary source: no ZIMRA statement was found on its own siteFreight clearance and crossing times at Beitbridge, two observations 2025-26
Selected milestones; each idea's page lists every dated item. Hover a source marker for the passage and whether a person has checked it.
Blockers
Each card keeps apart the constraint the sources report, what is expected to relieve it (and who expects it), and how much trade it holds back.
PhysicalInstitutionalSouth Africa · Zimbabwe
Truck crossings at Beitbridge took about two days on average in one week of July 2026
The constraint
A trade-press report of a weekly corridor report gives an average crossing time of 46 hours for 20 to 26 July 2026, with worst-case waits approaching four days. South Africa's Border Management Authority placed the cause on the Zimbabwean side. A SADC news item gave three to six hours for clearance in February 2025; that is a different measure and the two are not reconciled. Records: Beitbridge crossing times
Expected to relieve it
Six land ports of entry rebuilt, in the view of Border Management Authority. the upgrades would allow the implementation of the One-Stop Border Post model, "improving efficiency and coordination with neighbouring countries"BMA announces successful bidders for major border overhaul · article text, remarks of the BMA Commissionernot yet checked by a person
Private trains are contracted but not yet running, and the Act's rail access chapter is listed as not yet commenced in the version read, though the regulator itself is in force
The constraint
Eleven private operators concluded access agreements in May 2026. Operation Vulindlela targets their first operations for early 2027, and Transnet's infrastructure manager told them they would enter "a network that had been neglected". The Act's rail access chapter, which would let either side of a failed access negotiation refer it to the regulator, is listed as not yet commenced in the Law Library's commencement history (checked 26 October 2026), although the regulator was established on 1 April 2025 and a further part of its chapter commenced on 1 April 2026. That text predates the Amendment Act reported signed in March 2026, which was not read, so a later commencement cannot be ruled out. Records: Open access to freight rail, Transport Economic Regulator
For each blocker: the records that establish it, what is expected to relieve it and in whose view, and every institution those records name, by country. The arrow is a cited expectation; no role or order is drawn unless a record cites it.
Truck crossings at Beitbridge took about two days on average in one week of July 2026
5 institutions in 3 jurisdictions are named: South Africa, SADC, Zimbabwe. A cited role on these reforms is recorded for 1 of them; the others are named without one.
Six land ports of entry rebuiltin the view of Border Management Authority the upgrades would allow the implementation of the One-Stop Border Post model, "improving efficiency and coordination with neighbouring countries"BMA announces successful bidders for major border overhaul · article text, remarks of the BMA Commissionernot yet checked by a personDelivery Targeted · 2026Funding Unknown
institutions these records name
What the sources say they do
implementsBMA named the successful bidders for rebuilding the six land ports the Border Management Authority named bidders for Beitbridge and Oshoek (Baobab Concession), Lebombo (Raulux Consortium), Maseru Bridge (Kgorong Consortium), Kopfontein (Kopfontein Consortium) and Ficksburg Bridge (Imbani Consortium)BMA announces successful bidders for major border overhaul · article text · 28 Apr 2026paraphrase, not a quotation
Private trains are contracted but not yet running, and the Act's rail access chapter is listed as not yet commenced in the version read, though the regulator itself is in force
5 institutions in 1 jurisdiction are named: South Africa. A cited role on these reforms is recorded for 1 of them; the others are named without one.
Transport Economic Regulatorin the view of Operation Vulindlela (The Presidency and National Treasury) "The TER will be fully operational from April 2027"Operation Vulindlela progress report, Q1 2026/27 · p.10 · target: Apr 2027not yet checked by a personLegal In force · 1 Apr 2026Delivery Targeted · Apr 2027Funding Unknown
institutions these records name
What the sources say they do
decidesTER would rule on rail access disputes referred to it, once the Act's rail access chapter commences (it is listed as not yet commenced in the version read) the commencement history lists "Chapter 2 (section 5–10)" among provisions "not yet commenced"; s.8(2) would let either party to a failed access negotiation "refer the matter to the Regulator for resolution"Economic Regulation of Transport Act 6 of 2024, with commencement history · commencement history; s.8(2)not yet checked by a person
Institutions the area's records name. 5 cited roles on this area's reforms are shown on each reform's page, and under a blocker where that reform is expected to relieve it. The others are named without a role.
Connections between countries, each with the evidence it rests on and what it does not establish.
Joint action or dependency
South Africa has named a bidder to rebuild its side of Beitbridge, with construction at some ports expected to start late in 2026 or early in 2027, and the Border Management Authority expects the work to allow a one-stop border post. In July 2026 the same authority placed the cause of truck queues on the Zimbabwean side. If that is right, crossing times depend on both governments, and the South African works alone would not settle them.
What the evidence establishes
(1) A constraint exists: a trade-press report of a weekly corridor report gives a 46-hour average crossing in one week of July 2026; the report itself was not read. (2) The redevelopment is expected to improve efficiency and coordination with neighbours: the BMA's statement. (3) How much crossing time the works would save: unresolved.
the Border Management Authority named bidders for Beitbridge and Oshoek (Baobab Concession), Lebombo (Raulux Consortium), Maseru Bridge (Kgorong Consortium), Kopfontein (Kopfontein Consortium) and Ficksburg Bridge (Imbani Consortium) the Border Management Authority named bidders for Beitbridge and Oshoek (Baobab Concession), Lebombo (Raulux Consortium), Maseru Bridge (Kgorong Consortium), Kopfontein (Kopfontein Consortium) and Ficksburg Bridge (Imbani Consortium)BMA announces successful bidders for major border overhaul · article text · 28 Apr 2026paraphrase, not a quotation
"construction will begin later this year or early next year for some ports", with a "phased rollout" over "about a two-to-three-year period" (about three years at Beitbridge and Lebombo) "construction will begin later this year or early next year for some ports", with a "phased rollout" over "about a two-to-three-year period" (about three years at Beitbridge and Lebombo)BMA announces successful bidders for major border overhaul · article text · target: later this year or early next year (said 28 April 2026)not yet checked by a person
the upgrades would allow the implementation of the One-Stop Border Post model, "improving efficiency and coordination with neighbouring countries" the upgrades would allow the implementation of the One-Stop Border Post model, "improving efficiency and coordination with neighbouring countries"BMA announces successful bidders for major border overhaul · article text, remarks of the BMA Commissionernot yet checked by a person
the BMA attributes the July 2026 queues to "congestion on the Zimbabwean side of the border"; Zimbabwean authorities cited limited parking, abnormal loads occupying bays and slower processing by clearing agents the BMA attributes the July 2026 queues to "congestion on the Zimbabwean side of the border"; Zimbabwean authorities cited limited parking, abnormal loads occupying bays and slower processing by clearing agentsBMA blames Zimbabwean bottlenecks for freight truck delays at Beitbridge · article text · 26 Jul 2026not yet checked by a personSecondary source: no BMA statement or Zimbabwean statement was found
Joint action or dependency

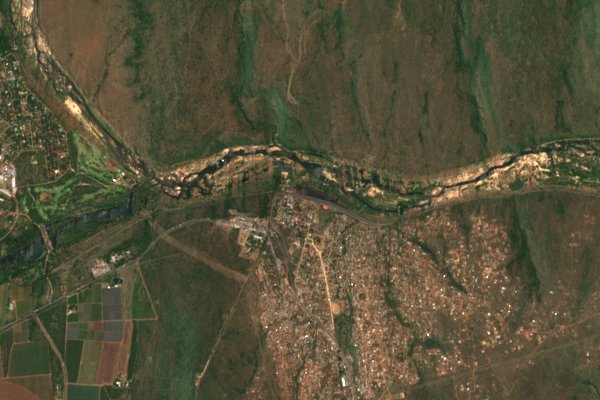

Both sides of the Lebombo and Ressano Garcia crossing are to be rebuilt. Mozambique broke ground at Ressano Garcia in August 2026. South Africa named a bidder for Lebombo in April 2026 and expects construction at some ports to start late in 2026 or early in 2027; no source read says work at Lebombo has begun. Both statements describe a one-stop border post, which by the Mozambican description means completing both countries' procedures at a single facility. A one-stop post therefore needs both governments, and the sources read do not show that the two projects are coordinated.
What the evidence establishes

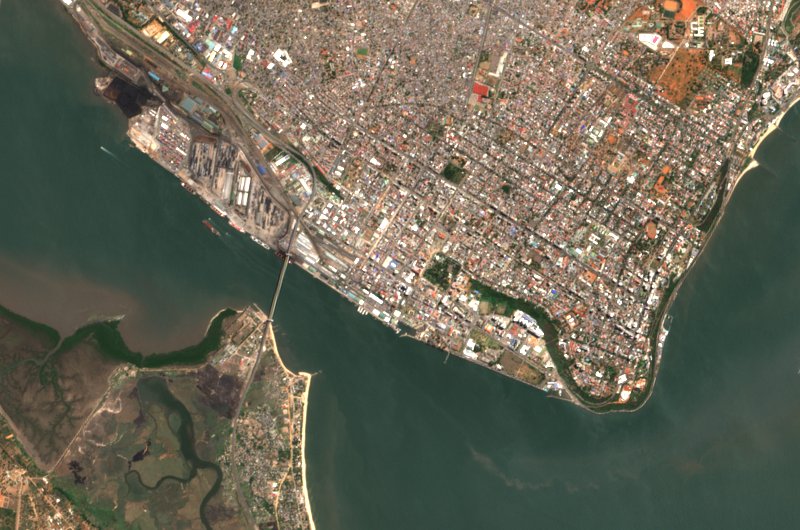

(1) No constraint at this crossing is recorded here: no crossing-time figure was read. (2) Each government's project is expected to allow a one-stop model: the BMA's statement and a press report of the Mozambican launch. (3) Any effect on crossing times: unresolved.
the Border Management Authority named bidders for Beitbridge and Oshoek (Baobab Concession), Lebombo (Raulux Consortium), Maseru Bridge (Kgorong Consortium), Kopfontein (Kopfontein Consortium) and Ficksburg Bridge (Imbani Consortium) the Border Management Authority named bidders for Beitbridge and Oshoek (Baobab Concession), Lebombo (Raulux Consortium), Maseru Bridge (Kgorong Consortium), Kopfontein (Kopfontein Consortium) and Ficksburg Bridge (Imbani Consortium)BMA announces successful bidders for major border overhaul · article text · 28 Apr 2026paraphrase, not a quotation
"construction will begin later this year or early next year for some ports", with a "phased rollout" over "about a two-to-three-year period" (about three years at Beitbridge and Lebombo) "construction will begin later this year or early next year for some ports", with a "phased rollout" over "about a two-to-three-year period" (about three years at Beitbridge and Lebombo)BMA announces successful bidders for major border overhaul · article text · target: later this year or early next year (said 28 April 2026)not yet checked by a person
the upgrades would allow the implementation of the One-Stop Border Post model, "improving efficiency and coordination with neighbouring countries" the upgrades would allow the implementation of the One-Stop Border Post model, "improving efficiency and coordination with neighbouring countries"BMA announces successful bidders for major border overhaul · article text, remarks of the BMA Commissionernot yet checked by a person
"Mozambique has broken ground on a 980-million-metical (about R260m) modernisation of the Ressano Garcia border post"; the project was launched on 17 August "Mozambique has broken ground on a 980-million-metical (about R260m) modernisation of the Ressano Garcia border post"; the project was launched on 17 AugustWork starts on Ressano Garcia border upgrade · article text · 17 Aug 2026not yet checked by a personSecondary source: no Mozambican government statement was found; the article credits 360 Mozambique
"A one-stop border model will allow travellers to complete South African and Mozambican entry and exit procedures at a single facility" "A one-stop border model will allow travellers to complete South African and Mozambican entry and exit procedures at a single facility"Work starts on Ressano Garcia border upgrade · article textnot yet checked by a personSecondary source: no Mozambican government statement was found
Evidence limits
What the records do not establish, said once here rather than on every claim. Coverage says what was read; the lists say what it leaves open.
Coverage
Seven records. Five are on South Africa's side or at Beitbridge: open access to freight rail, the transport regulator, private participation in ports and rail, the land ports of entry partnership, and crossing times at Beitbridge. Two are on Mozambique's side of the Maputo corridor: the Ressano Garcia border post and the railway to Maputo. Sources are Operation Vulindlela reports, the Act, a government news report, a SADC news item, a financier's project page and press reports. No Zimbabwean reform is recorded, no Mozambican government document was read, and the Walvis Bay and North-South corridors beyond Beitbridge are not covered.
How much trade or investment each blocker holds back
